Self-consumption

Information on modalities, procedures and regulations

On this page, we explain what self-consumption is, the available modalities, the procedures you need to carry out with us, and where you can request each service. At the end, you will find the relevant regulatory framework

Collective self-consumption and regulation

MODALITIES OF SELF-CONSUMPTION

What is self-consumption?

Self-consumption is the use of electrical energy generated at an installation close to the consumption point and linked to one or more consumers. It can be individual or collective.

Self-consumption modalities

Modality

What it means

Self-consumption without surplus

The installation has a zero-export (anti-spill) system. Therefore, excess energy is not injected into the grid.

Self-consumption with surplus

The installation can cover your consumption and, additionally, feed excess energy into the grid.

How the installation can be connected

Type of connection

When it applies

Nearby installation via internal network

When the installation is connected to the consumers' internal network or via direct lines.

Nearby installation via the grid

When the installation is connected via the distribution network and meets any of these conditions: it belongs to the same low-voltage network as the transformer substation; if it is low voltage, the distance between generation and consumption is less than 2,000 m or 500 m, depending on the technology; or both fall under the same cadastral reference.

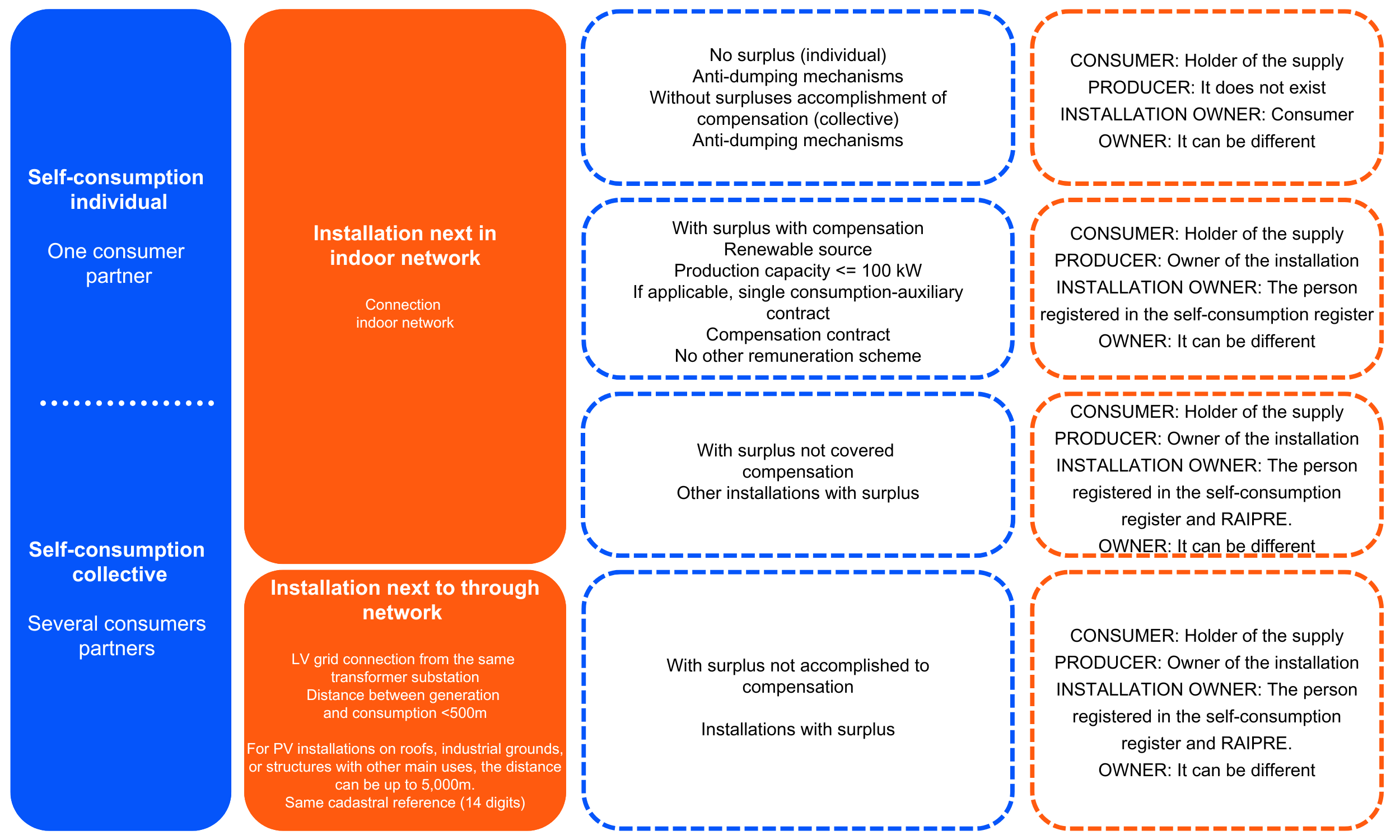

The detailed regulations for these modalities and their requirements are set out in Royal Decree 244/2019. You can also consult the IDAE Guide to Self-Consumption Procedures.

(Source: Guía de Tramitación del Autoconsumo IDAE

 What procedures must you carry out with us?

If your installation is for self-consumption with surplus, these are the main procedures:

1. Request for access and connection

You must submit a generation access and connection request to us as the distribution company.
You do not need this procedure if your installation meets all these requirements:

  • it has a surplus;
  • the generation capacity is 15 kW or less;
  • it is located on urbanised land with the amenities and services required by urban planning regulations;
  • and it is connected to the internal network.

You can submit the request in the private area of our website.

2. Response to the preliminary proposal

If you have requested access and connection, we will reply with:

  • the connection point to the distribution network;
  • and the technical and financial conditions for any works that may need to be carried out on the grid.

3. Works on the distribution network

If you accept the technical and financial conditions, we will issue the access and connection permits and carry out the technical works necessary to connect your installation.

4. Technical Access Contract (CTA)

The Technical Access Contract (CTA) governs the technical relationship between us and you from the moment of connection. You can request it via the 'CTA Request' service in the private area.
If your installation does not require the access and connection procedure, you will not need to sign a CTA.

5. Metering configuration verification

Once the installation is finished and legalised, we must verify the metering configuration before connecting it to the grid.
You must request this verification by emailing: Inspeccionautoconsumo@enel.com.
This check is carried out in accordance with Royal Decree 1110/2007.

6. Certificates from the Meter Administrator and Grid Manager

If you need to register your installation as a producer, you must request the certificates stipulated in Article 39.1.d) of Royal Decree 413/2014 from us.
You can request them at: Conexiones.edistribucion@enel.com.

7. Updating the contract with your energy supplier

For your supply contract to reflect your chosen self-consumption modality, you must contact your energy supplier and request a contract update.
Once that contract has been adapted, the installation can enter into service.
If your installation generates a surplus, you can offset it on your bill when the power capacity is up to 100 kW, or sell it on the market, depending on the chosen modality.

Specific case: nearby installations via the distribution network

If your installation is nearby via the distribution network, requires a new connection point, has a production capacity of 15 kW or less, and is located on urbanised land with the amenities and services required by urban planning regulations, you must submit a request for us to assess and manage:

  • the connection works reserved for the distribution company;
  • and, where applicable, the provision of auxiliary services.

Guide for the connection of self-consumption installations

You will find all relevant information for the connection of self-consumption systems.

FAQs
Electric self-consumption

More information and queries

If you have a general query about self-consumption, you can use the web form.
If you need to submit documentation for an ongoing application or discuss billing or bank transfer issues, you can email conexiones.edistribucion@enel.com.

Regulatory framework

  • Royal Decree 244/2019.
  • Royal Decree 1110/2007.
  • Article 39.1.d) of Royal Decree 413/2014.
  • Royal Decree 647/20.
  • Low Voltage Electrotechnical Regulations (REBT).
  • IDAE Guide to Self-Consumption Procedures.



TXT file validator for collective self-consumption



If you need to validate the TXT file with the distribution coefficients, you can use the form available on the website.
The validator checks the file for formatting errors. It does not verify whether the CUPS are incorrect or non-existent.
